Schedule&Cost Management for Whistler Ski Resort Project
-
1. Introduction
I was the project manager to manage the schedule and cost part of Whistler Ski New Resort. Whistler Ski Association considered construction of another ski lodge and ski complex. This project has three stage, I was responsible for the first stage.
-

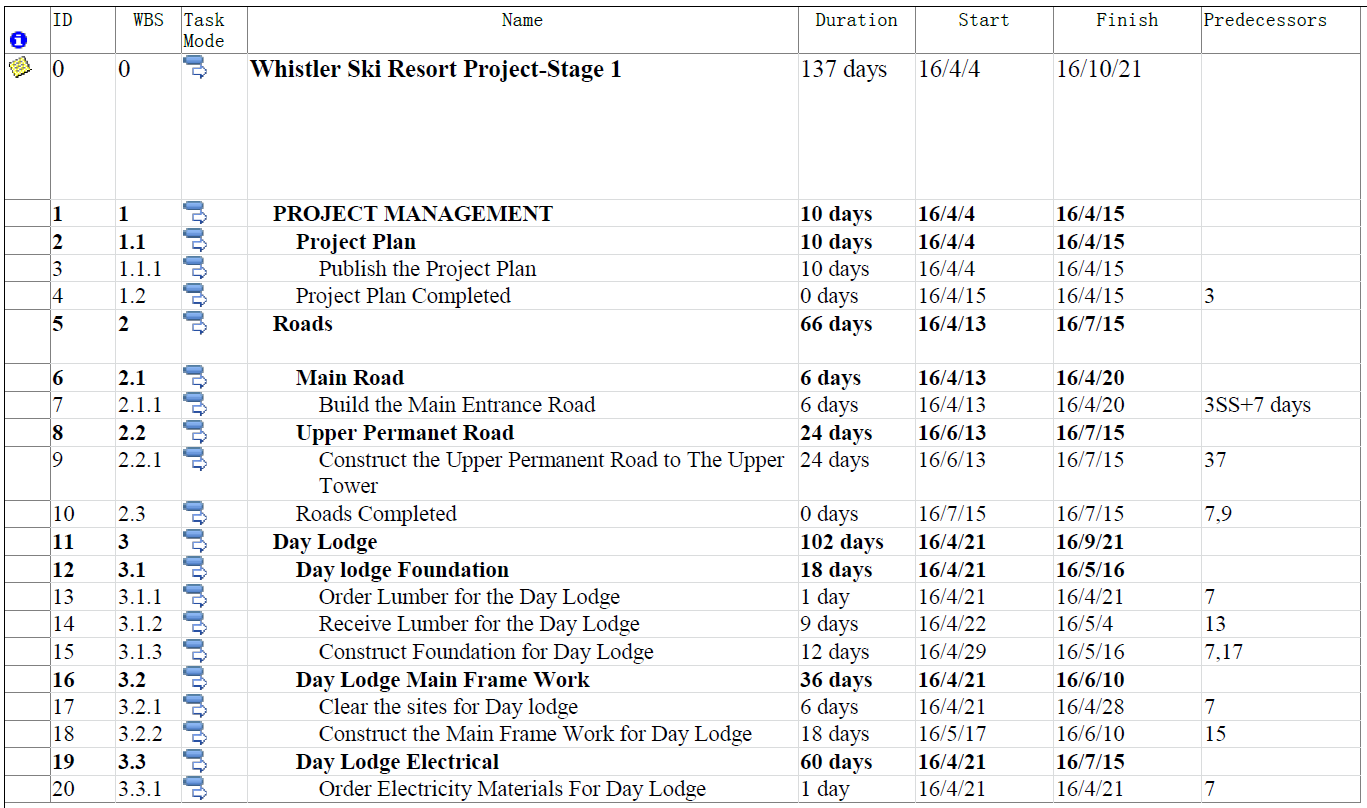

2. Initial Work Breakdown Structure & Schedule Arrangement

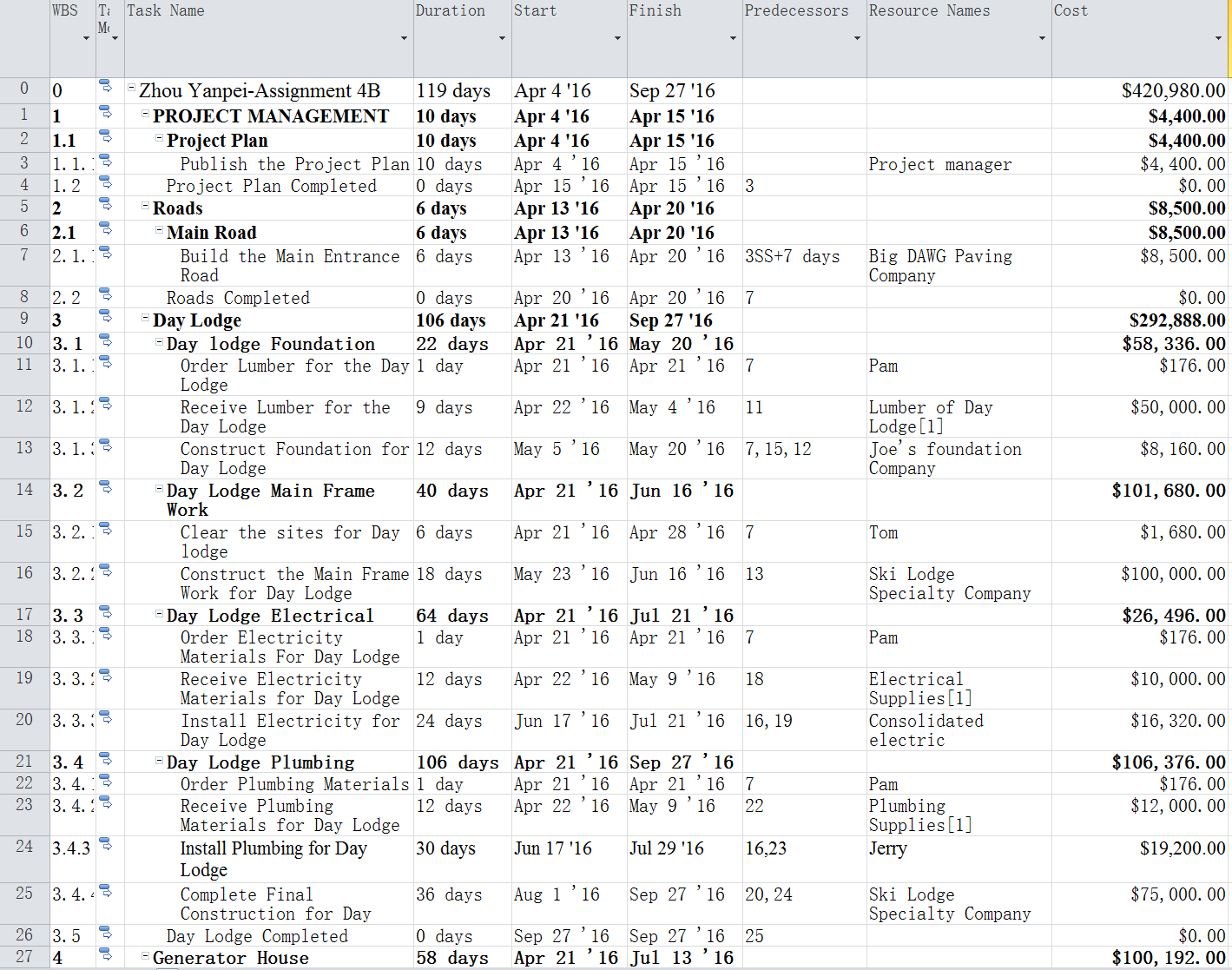

Work Breakdown structure and schedule assigning from MS Project.
3. Work Breakdown Structure & Resource Arrangement
In the process, our clients changed some procedures, because the Whistler Association faced some budget problem. The work breakdown structure and resource assigning arranged at MS Project.

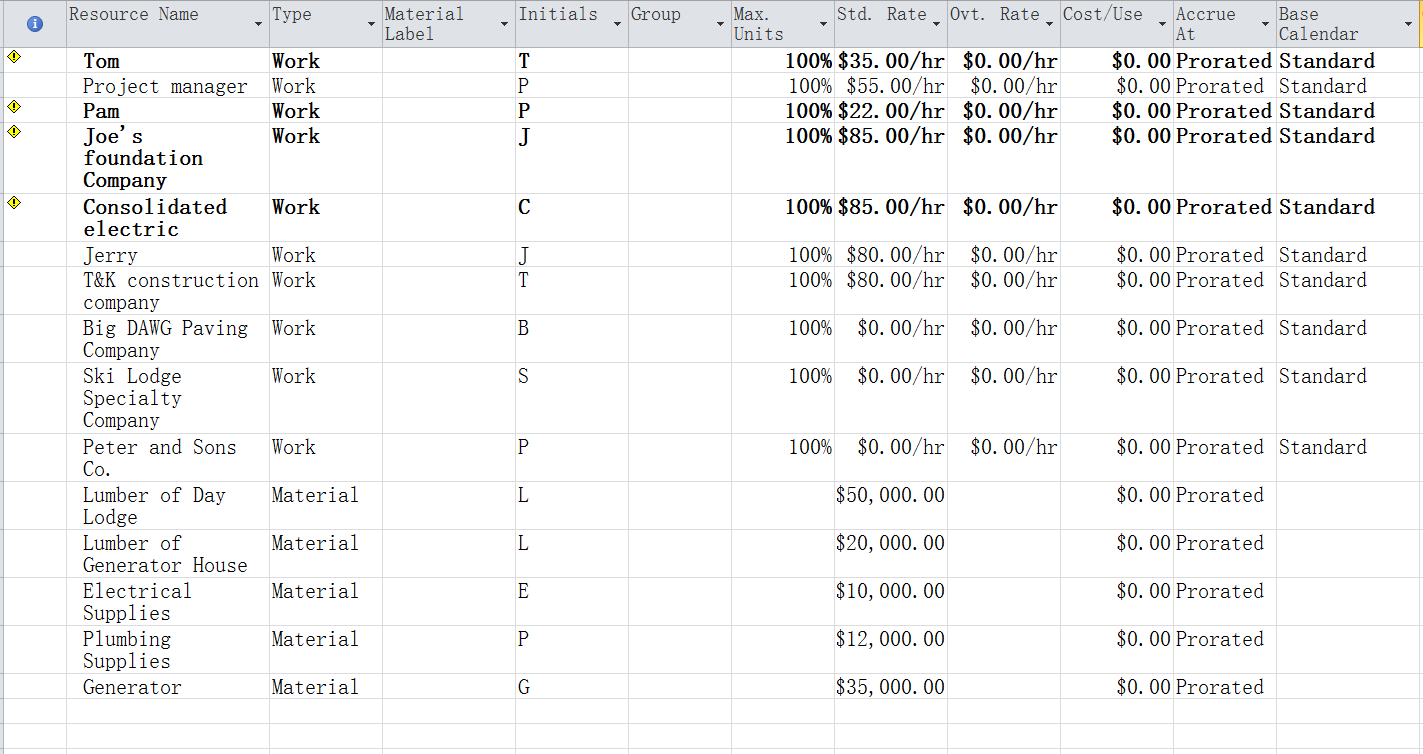

3.1. Resource

3.2. Work Breakdown Structure after scope changing
-

4. Mark on Track of Work Progress

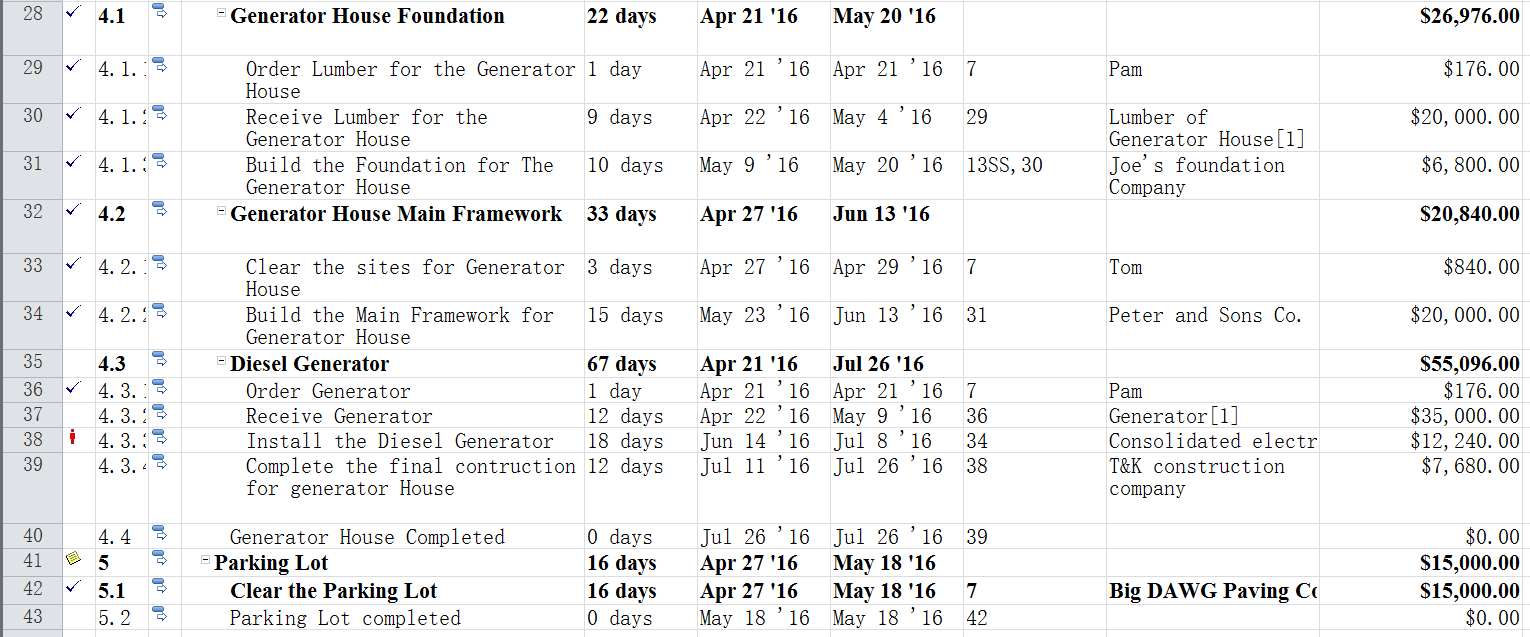

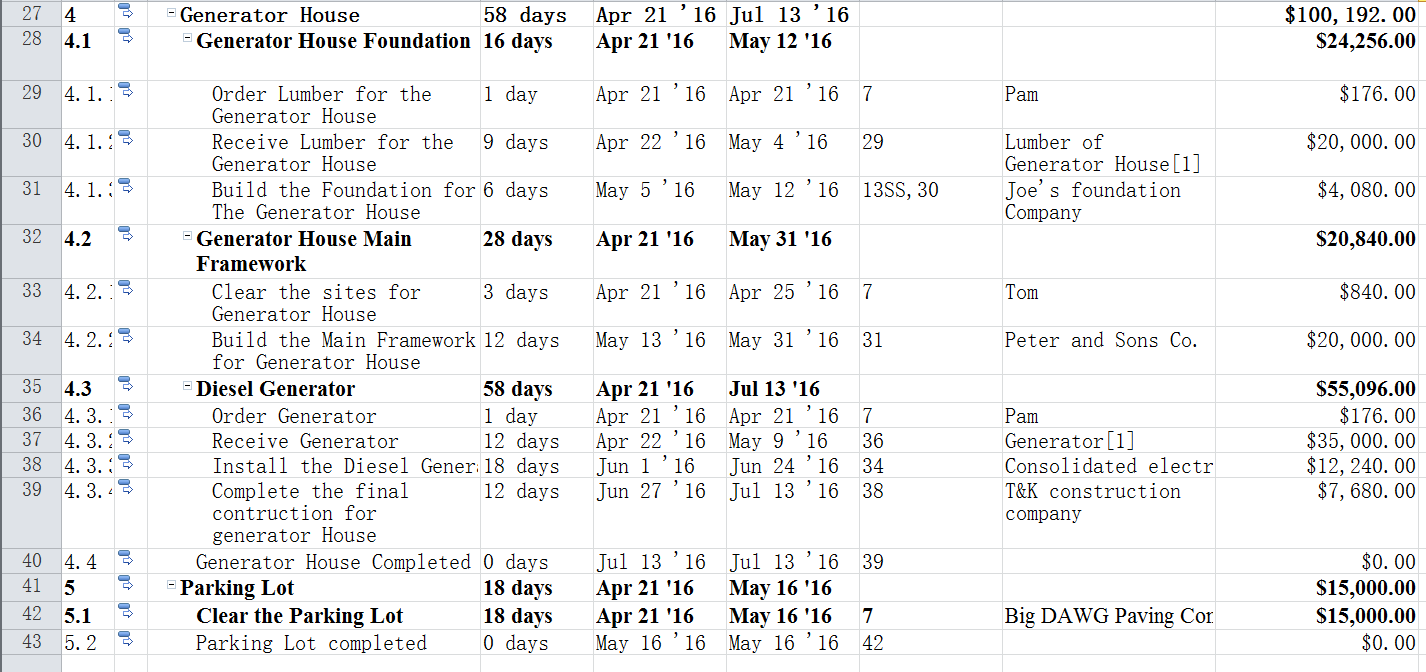

Mark the check the finished work from MS Project.
-

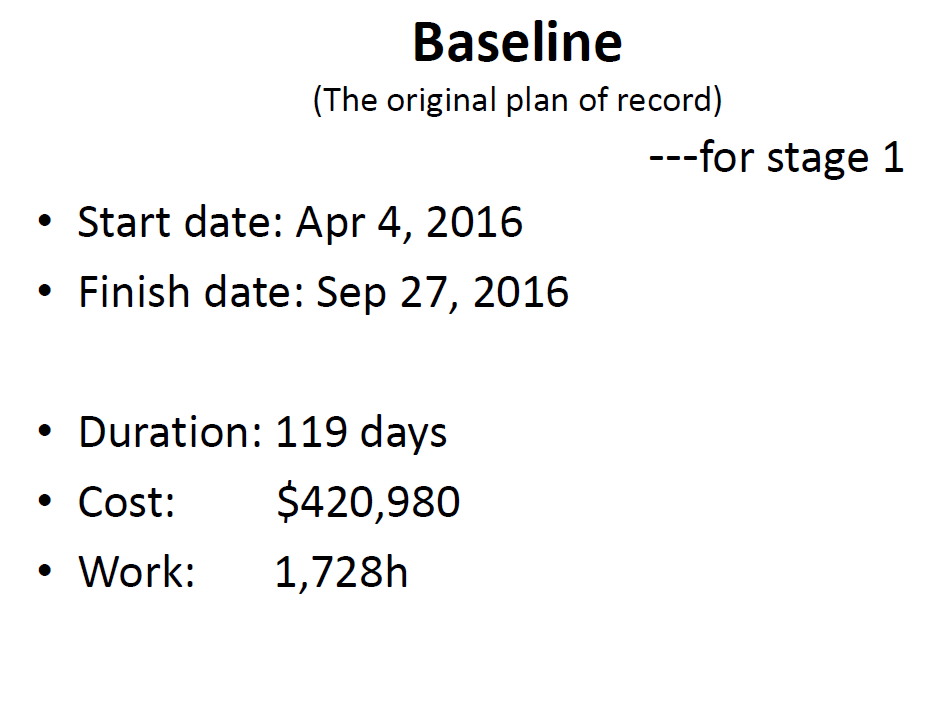

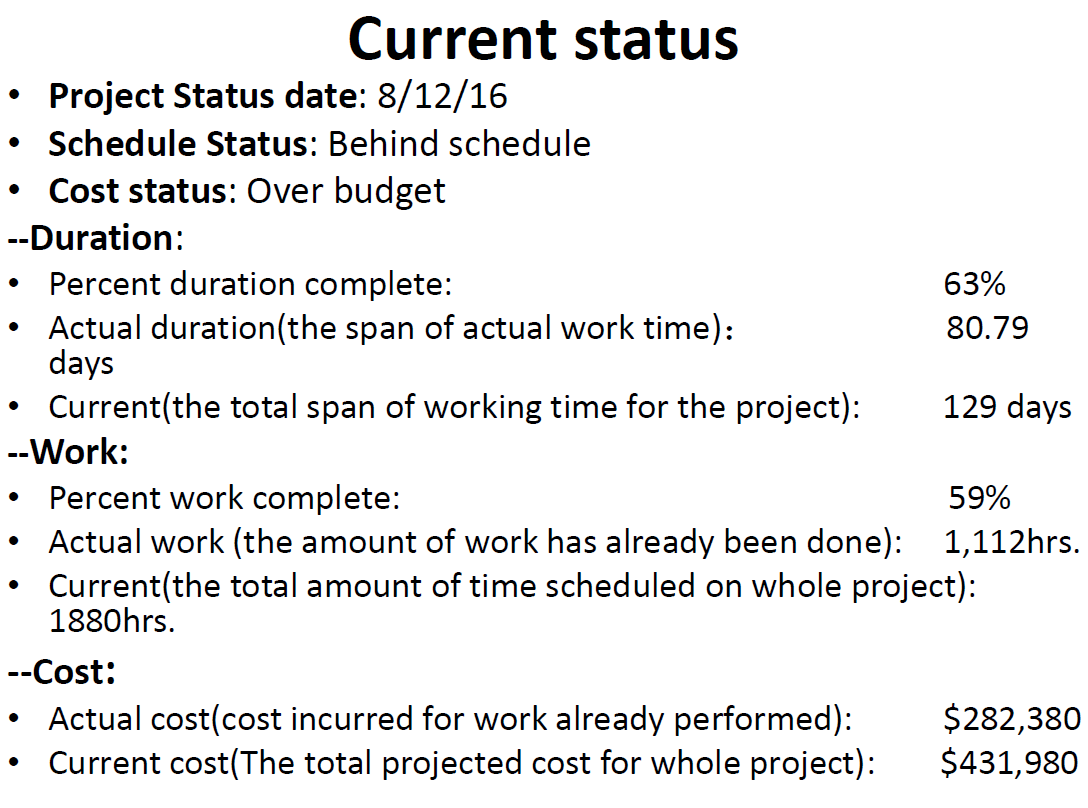

5. Executive Summary Report
This report used MS PowerPoint. It presents the current status and the original baseline to stakeholder and manager. It is used to track the progress, prevent risk and find the potential schedule and cost overrun problem.
Comments
Write a Comment
2 Comments
plus size adult onesie wrote:
You’ve made some really good points there. I checked on the net for more information about the issue and found most people will go along with your views on this web site.
Jasper Vranich wrote:
I’m still learning from you, but I’m trying to reach my goals. I definitely liked reading everything that is posted on your website.Keep the stories coming. I loved it!
There aren't currently any comments on this blog entry.
